Home State Landslide on Mumbai-Pune Missing Link Disrupts Traffic; MSRDC Calls Incident an ‘Act of God’
State - 2 hours ago

Landslide on Mumbai-Pune Missing Link Disrupts Traffic; MSRDC Calls Incident an ‘Act of God’

Mumbai, July 2026: Heavy monsoon rains battered Maharashtra over the past two days, triggering a major landslide on the recently inaugurated Mumbai-Pune Missing Link in the early hours of Monday. The incident disrupted traffic on one of the state’s most ambitious infrastructure projects, forcing authorities to suspend movement on the Pune-to-Mumbai carriageway while restoration work continues.

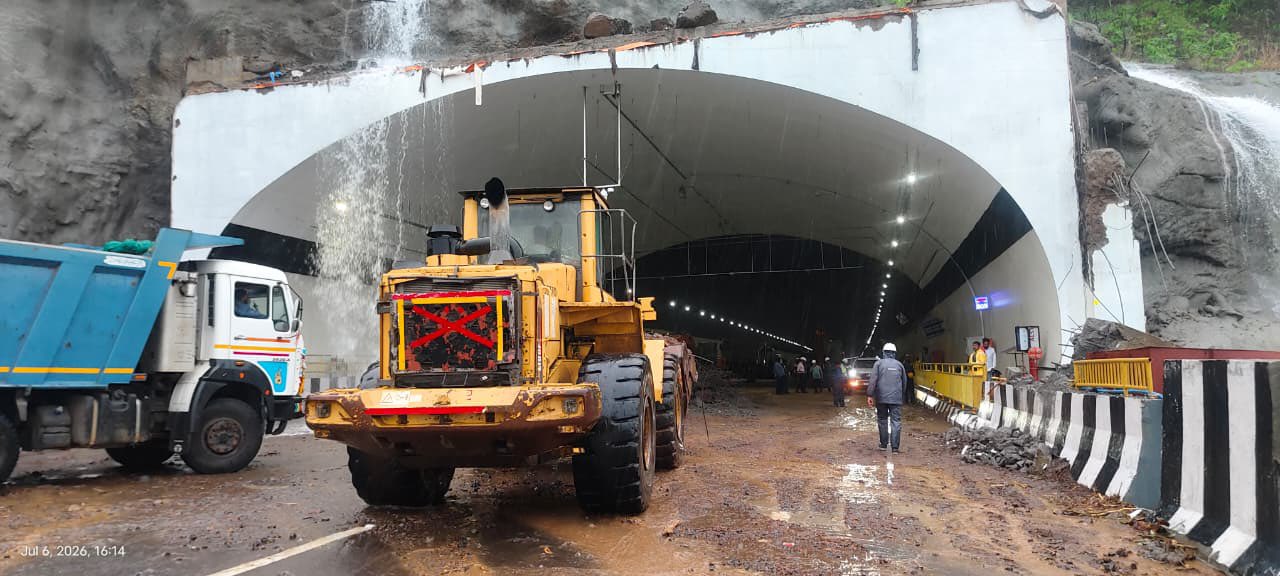

The landslide occurred around 3:30 a.m. near the exit of the first tunnel on the Pune-to-Mumbai stretch of the 13.3-km Missing Link, which was opened to commuters just two months ago. Huge rocks and debris tumbled down the hillside, damaging the protective retaining wall and making the section unsafe for vehicular movement.

The Maharashtra State Road Development Corporation (MSRDC), which executed the project, described the incident as an “Act of God”, asserting that the landslide was caused by unprecedented natural forces rather than any engineering or construction failure.

Senior MSRDC officials defended the quality of the project, stating that the contractor had adhered to all prescribed safety standards. According to the corporation, extensive landslide mitigation measures had already been incorporated into the project design, although such systems have inherent limitations when faced with extreme weather events.

Officials explained that the hillside above the tunnel had been secured with rock bolting and iron mesh netting extending up to 15 metres. These protective measures, designed in consultation with experts and certified by IIT Bombay, remain intact despite the incident.

However, the massive boulders that struck the roadway reportedly originated from nearly 150 metres above the tunnel, well beyond the height of the installed protective barriers. MSRDC officials said that preventing such large-scale rockfalls becomes virtually impossible during exceptionally heavy rainfall, which they described as “divine wrath-like” conditions.

The corporation also highlighted that the existing safety barriers played a crucial role in reducing the impact of the landslide. According to officials, the retaining structures absorbed much of the force generated by the falling rocks, slowing their descent before they reached the roadway.

Authorities believe the damage could have been far more severe had these protective systems not been in place. The barriers prevented the boulders from directly crashing onto passing vehicles, potentially averting a major tragedy.

The incident comes just a day after the Missing Link project drew political attention over the appearance of potholes on parts of the newly opened stretch. Opposition parties criticised the state government over the quality of construction, while Chief Minister Devendra Fadnavis dismissed the issue as a minor defect that could be rectified quickly.

Following Monday’s landslide, the Pune-to-Mumbai carriageway has been completely closed to traffic. Vehicles travelling towards Mumbai are being diverted through the old Mumbai-Pune Highway (NH-48), while the Mumbai-to-Pune corridor has been restored and remains operational.

MSRDC teams have launched intensive debris removal operations to reopen the affected section at the earliest. Officials said heavy machinery has been deployed to clear rocks and mud from the roadway while engineers continue to assess the structural condition of the damaged retaining wall.

Once the monsoon season ends, the corporation plans to undertake a fresh geological survey of the surrounding hills to assess long-term risks. Based on the findings, authorities will evaluate the feasibility of extending the rockfall protection system higher up the slope.

Officials acknowledged that expanding the protective iron netting would involve substantial financial expenditure and require approvals from the forest department, as the proposed work would extend into forest land.

Despite the disruption, MSRDC maintained that the project’s core engineering remains sound and that the incident underscores the challenges of building infrastructure through steep mountainous terrain during increasingly unpredictable monsoon conditions. Authorities have assured commuters that safety remains the top priority as restoration and detailed inspections continue.
